Section 3: Managing Change Orders in DMS

Anchor: #i999727

Creating Change Orders

You can use the Change Orders & Task Orders tab to change a contract’s value or end date. When you change the value, you create an amendment to the existing contract that allows you to change the total value of the original contract and specify new values for meeting goals.

When you change the contract’s end date, you can end the contract on an earlier or later date than the current date on the contract.

Anchor: #i999744

Changing the Value of a Contract

Step 1: Log in to DMS.

Step 2: Locate desired contract and navigate to Contract Management page.

Step 3: Click the Change Orders & Task Orders tab.

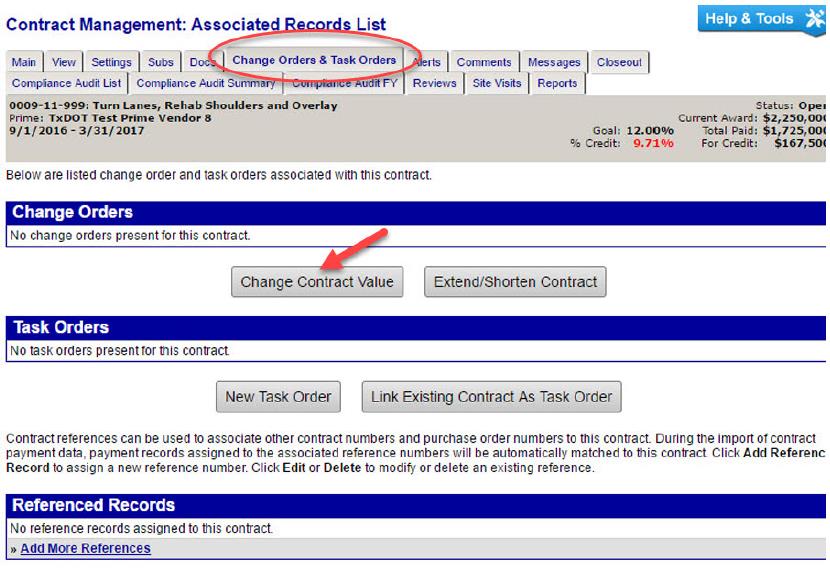

Step 4: Click Change Contract Value.

 (click in image to see full-size image)

Step 5: In the Change Order Information field, enter the Change Order Title.

Step 6: From the Change Order Date calendar selector, select a date for the amendment.

Step 7: In the Change Order Note field, enter additional information about the change order.

 (click in image to see full-size image)

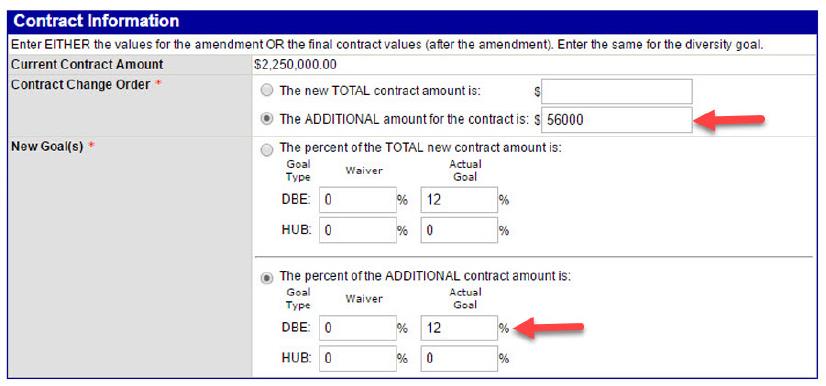

Step 8: In the Contract Information area, specify you are creating an amendment for the ADDITIONAL amount for the contract, and enter the amount.

Step 9: In the New Goal(s) area, specify you are creating an amendment for the percent of the ADDITIONAL contract amount is, and then enter the Waiver, and Actual Goal percentages for each category.

 (click in image to see full-size image)

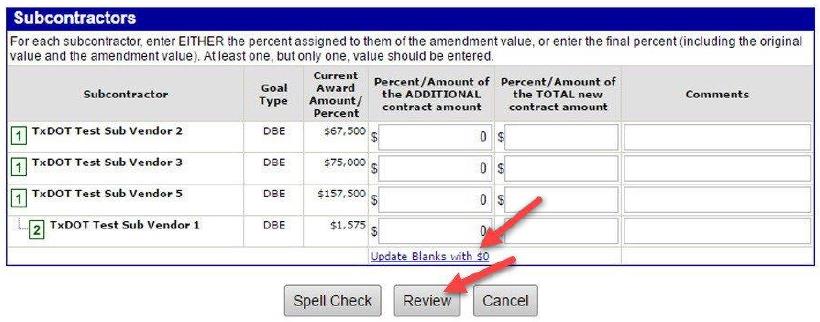

Step 10: In the Subcontractors box, click Update Blanks with $0.

Step 11: Click Review

 (click in image to see full-size image)

Step 12: Review Change Order Information and click Save.

 (click in image to see full-size image)

Anchor: #i999843

Changing the End Date of a Contract

Step 1: Log in to DMS.

Step 2: Locate desired contract and navigate to Contract Management page.

Step 3: Click the Change Orders & Task Orders tab.

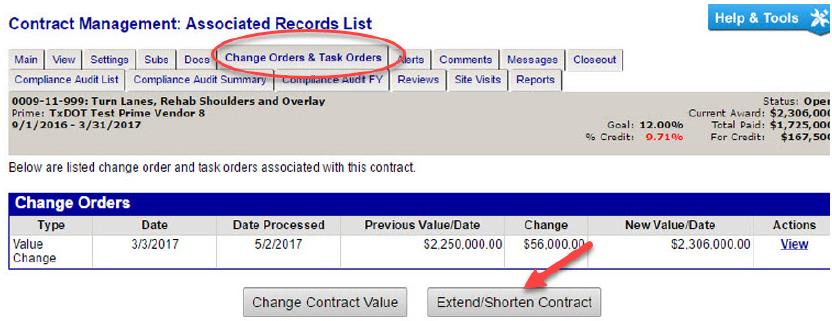

Step 4: Click Extend/Shorten Contract.

 (click in image to see full-size image)

Step 5: From the Extend/shorten contract to calendar selector, select the new date on which the contract ends.

Step 6: Click Review.

 (click in image to see full-size image)

Step 7: Review and then click Save.

 (click in image to see full-size image)
